Filament Project, Bellevue

|

Project Description

Filament consists of two eight-story mixed-use multifamily buildings. It includes 293 apartment units and 7,664 square feet of retail at grade. Both buildings have multi-story below-grade parking, which will accommodate 342 parking stalls. The project site is located at 10538 & 10588 NE 2nd St in downtown Bellevue. The project start date is targeting September 2026, and completion is estimated for December 2028.

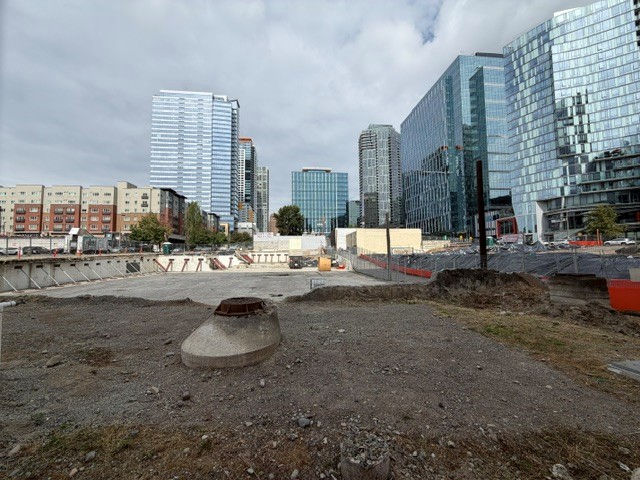

An urban construction site with gravel ground, surrounded by modern tall buildings under a cloudy sky.
  • Site Preparation & Preconstruction
    • Final project easement secured, completing the last major preconstruction milestone.
    • City of Bellevue preconstruction meetings for ROW, clearing & grading, and shoring completed.
    • Excavation startup planning, utility coordination, permitting, and sequencing efforts are ongoing.
    • PSE coordination on the pole relocations is ongoing, access on 2nd for mass ex dirt haul-out depends on it.
  • Mass Excavation & Shoring
    • Mass excavation mobilizes 9/10.
    • Contractor mobilization and site logistics planning complete.
    • Environmental, permitting, and sequencing activities ongoing to support excavation start.
    • Shoring scheduled to start 9/21.
  • Tower Crane
    • Tower crane foundation excavation planning is ongoing.
    • Excavation is targeting October completion to support crane erection before Bellevue's holiday moratorium.
  • Utilities
    • PSE confirmed transformers are reserved and available in April or May 2027.
    • Merlino is scheduled to start installing the PSE pathway, begin potholing operations, and perform cut-and-cap work.
  • Environmental
    • AECOM is scheduled to perform targeted soil sampling to further define contaminated soil locations.
    • Site monitoring cameras are scheduled to be installed prior to major excavation.



Project Update November 5, 2026:

Tower crane erection is scheduled to start at 6:00 AM on Saturday, 11/7, and continue through Sunday, 11/8.

During the erection, 106th Ave NE will be closed between NE 2nd St and just south of the mid-block crosswalk. Access to all businesses, parking garages, and parking lots will remain open during the work.

We'll have Local Access Only signs in place and a flagger stationed at NE 4th St to help direct traffic.

Thanks for your patience while we complete this work safely and get the crane installed. If you have any questions, please reach out to the project team.

Starting on 11/9 we start the foundation concrete so there will be lots of activity on 106th.
